DOE Annual Progress Review of the
Lattice Quantum Chromodynamics (LQCD) Computing Project

LQCD-EXT II

June 28-29, 2016

Thomas Jefferson National Accelerator Facility
CEBAF Center, Room F224-225


Agenda: updated 6/25/2016

Logistics:

Review Participants: Reviewers, Participants

Charge to the Review Committee: Charge Letter

Responses to Technical Questions: Technical Q&A ; 3-Sites Q&A

Responses to Science Questions: Science Q&A

LQCD-ext II Controlled Project Documentation

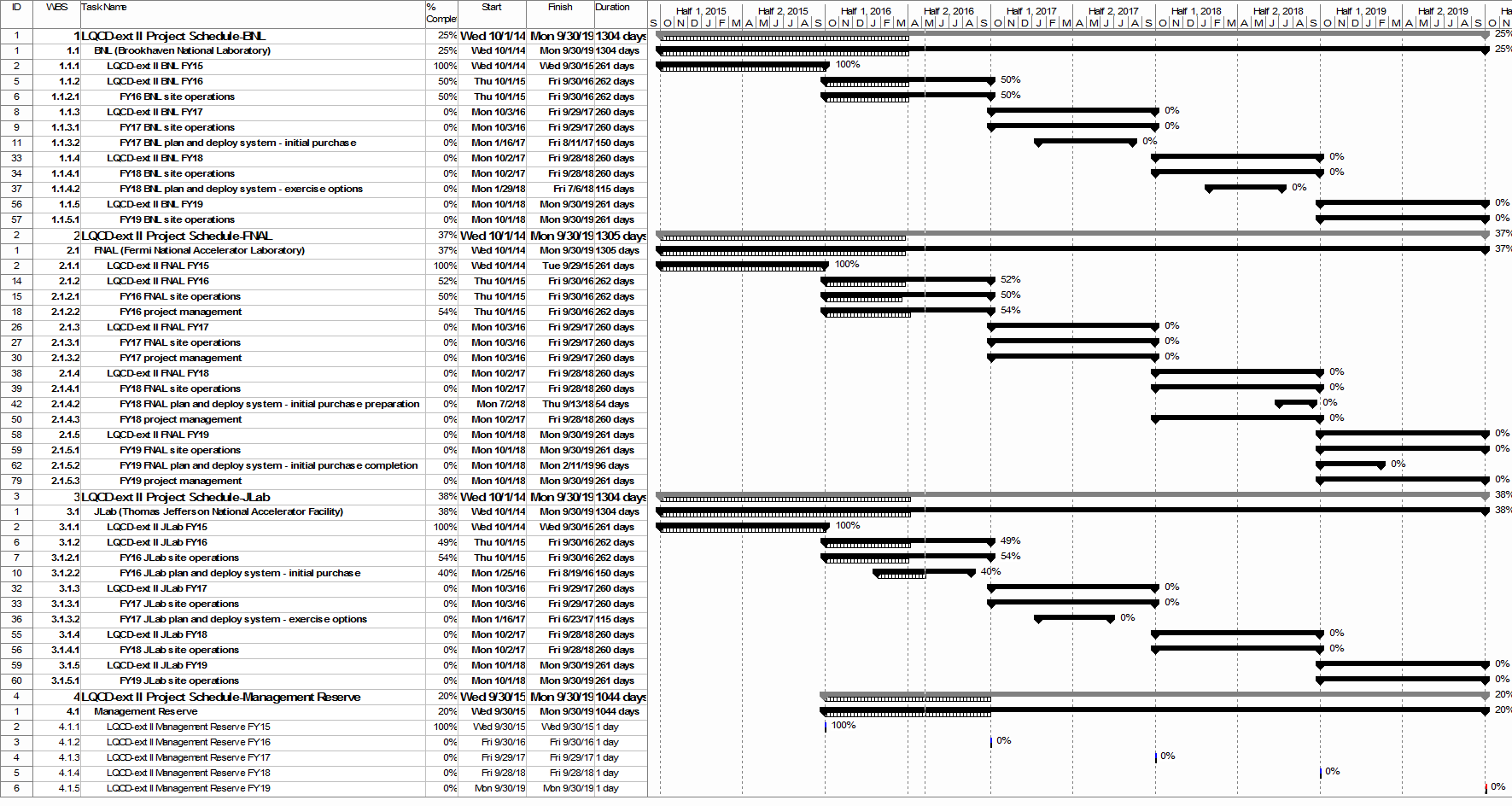

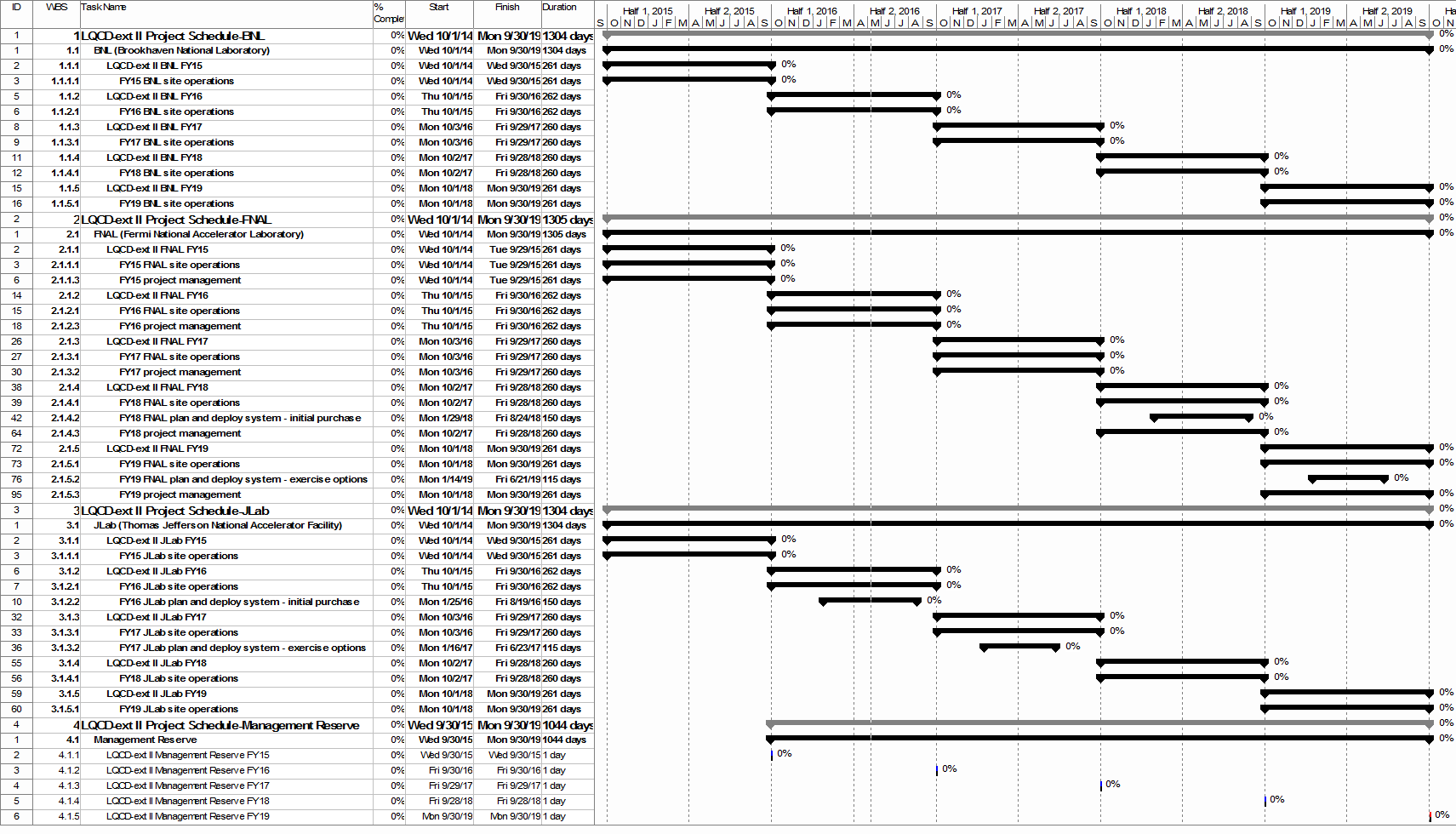

Project Baseline 2015

Project Change Request CR16-01: Three-Site Cluster-Hosting

Project Change Request CR16-02: Unified Performance Goals

Project Baseline 2: Changed documents after CR16-01,02 approvals

Other LQCD-ext II Project Documents

Past Project Review Reports and Submissions

USQCD Scientific Program Documentation

2013 White Papers

Other Documents
